Key Takeaway

The plan comes together in three final steps: a realistic timeline built around the client's deadlines, energy and dependencies; a clear cost estimate covering fees, supplies, vendors and removal; and a written plan the client reviews and approves before implementation begins. Estimates are honest ranges, changes are agreed before they happen, and the plan stays a living document.

This lesson completes Domain III with the last three outline items: establishing a project timeline (III.F), estimating cost — consulting fees, supplies and vendors (III.G) — and finalizing the project plan (III.H). By now the organizer has reviewed the assessment with the client, agreed the scope and priorities, broken the work into tasks (Lesson 7) and lined up resources, referrals and removal routes (Lesson 8). What's missing is when it will happen, what it will cost, and a single written plan the client can say yes to.

These three items look administrative, but they carry a lot of the exam's judgement questions. A timeline that ignores the client's energy, an estimate given before assessment, or extra work started without agreement are all classic wrong answers. After this lesson the project moves into Domain IV, Implementation, which Lessons 10–15 cover.

Free on YouTube Subscribe to get every lesson video in this course Subscribe

Establishing a Timeline (III.F)

A timeline turns the task list from Lesson 7 into dates and sessions. A good one is realistic for this client — not for an average client, and not for the organizer's ideal week. It's built from five inputs:

What shapes a timeline
  • DeadlinesMove dates, a house sale, visiting family, a new baby, the start of a school year. With a fixed deadline, plan backward from it.
  • The client's energy and availabilitySession length and frequency sized to stamina, decision-making capacity and schedule (Lessons 5 and 13).
  • DependenciesVendor bookings, deliveries, donation pick-ups, and tasks that must happen before others.
  • Between-session tasksRealistic time for the client to complete their own tasks between visits.
  • BufferTasks usually take longer than planned, and illness, difficult decisions and vendors cause delays. Build slack in.

Planning backward from a fixed deadline

When there's a date that can't move — the removal truck arrives, the keys are handed over — the organizer starts at the deadline and works back. Each step asks: what must be finished before this can happen, and how long will it realistically take? Here's a simplified example for a client moving out in five weeks:

WhenWhat must be doneWhy it sits here
Move dayMovers load; organizer supervises labelled boxesThe fixed deadline
Week 5Buffer; pack daily-use items lastAbsorbs delays without touching the deadline
Week 4Pack rooms that are already edited; confirm moversOnly edited rooms get packed — no paying to move clutter
Week 3Donation pick-up; sale items collected; shredding serviceRemoval routes need lead time (Lesson 8)
Weeks 1–2Sort and edit, hardest categories early; book vendorsDecisions take the longest and set the volume to move

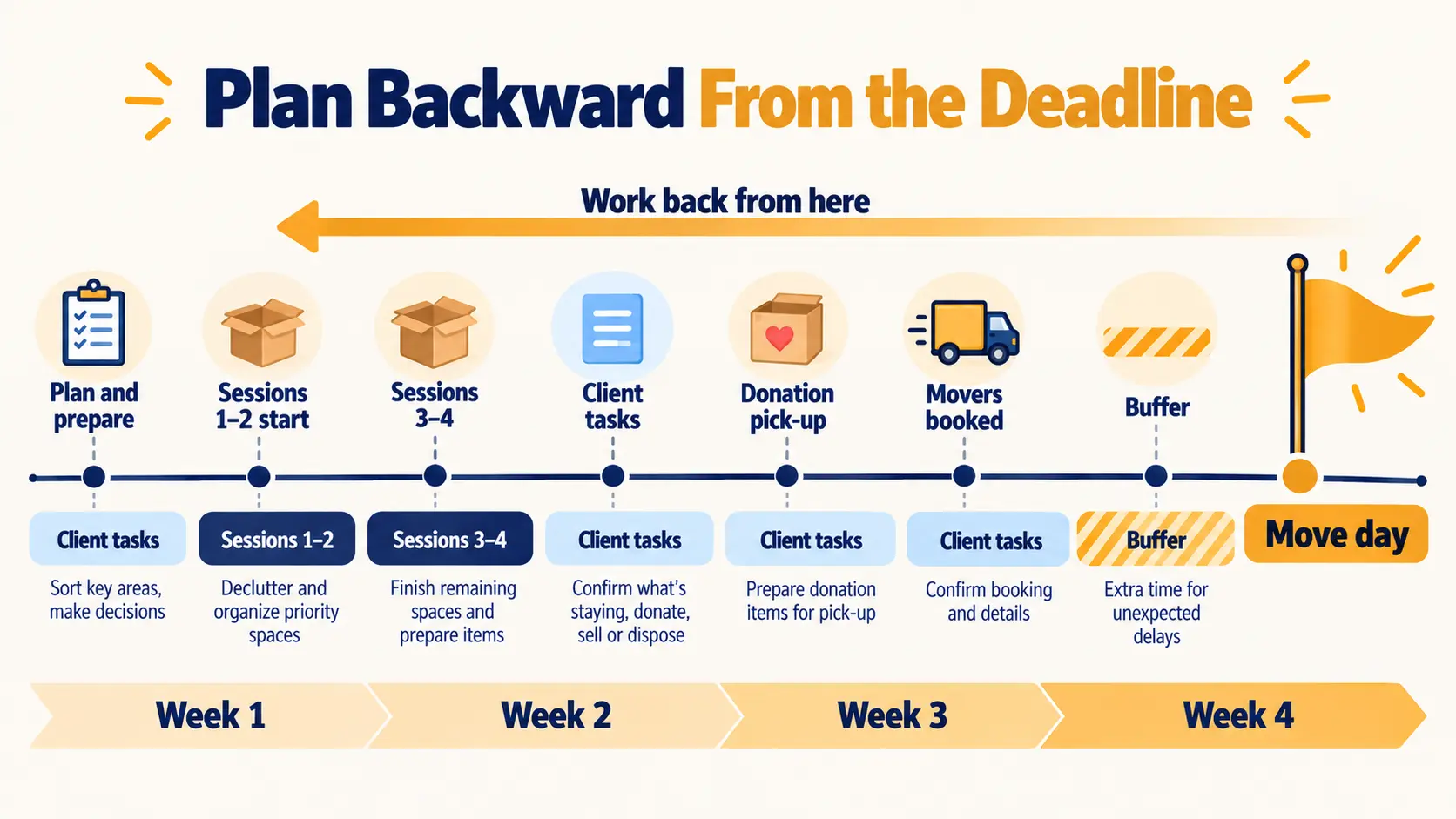

Timeline planned backward from a move date, showing sessions, a donation pick-up, a mover booking and buffer time before the deadline.

Notice two things. The buffer sits before the deadline, not after it. And the slowest, most decision-heavy work goes first, because it sets the volume for everything that follows.

Sizing sessions to the client

Session length and frequency come from the assessment, not from the organizer's preferred booking pattern. Decision-making is tiring, and most clients make poorer decisions as fatigue builds. Some common adjustments:

  • Shorter, more frequent sessions for clients with limited stamina, chronic pain or attention differences, or when the material is emotionally heavy, such as a late parent's belongings.
  • Longer sessions where the work is physical and momentum helps — clearing a garage with a client who has the energy for it.
  • Gaps between sessions long enough for between-session tasks, donation drop-offs and deliveries, but short enough that momentum isn't lost.
  • The client's calendar — work, caring responsibilities, religious and cultural observances, school terms.

Dependencies and sequencing

Some tasks can't start until others finish. Shelving has to be installed before the books go back. A filing system can't be set up until the paper has been sorted. A consignment shop may only accept seasonal items at certain times. Vendors need booking ahead, and deliveries arrive on their schedule, not yours. A timeline that ignores dependencies looks fine on paper and collapses in week two.

How much buffer?

There's no fixed percentage. The more unknowns, the more buffer: a first-time client, a large volume of sentimental items, several decision-makers, or vendors the organizer hasn't used before all call for more slack. A client who decides quickly, with a small, well-defined space, needs less. What the exam cares about is that buffer exists and that the timeline is realistic.

🎯 How the exam tests III.F. Expect scenarios with a deadline and ask yourself what the client can realistically do. The right answer usually plans backward, sizes sessions to the client, and includes buffer. Wrong answers cram everything into the last week, book the maximum number of sessions up front, or copy the pace of a previous client.

Estimating Cost (III.G)

The outline names three cost areas — consulting fees, supplies and vendors — and a complete estimate adds removal and disposal, so the client sees the whole picture before deciding.

Cost areaTypically includes
Consulting feesEstimated sessions × rate (or a package or project fee), planning time, travel
SuppliesContainers, shelving, labels and furniture still needed after shopping the house
VendorsMovers, cleaners, handypeople, shredding, storage, appraisers
Removal and disposalJunk removal, recycling or hazardous-waste fees

Fee structures

Organizers charge in different ways, and the estimate should make clear which one applies. The exam won't test rates — they vary widely by location and specialty, so no currency figures appear in this course — but it does expect you to know the common structures and to explain them openly.

StructureHow it worksWorth explaining
HourlyTime on site × hourly rateMinimum session length; whether planning, shopping and travel are billed
PackageA set number of hours or sessions for a set feeWhat happens if the hours run out or go unused
Project feeOne fee for a defined scopeExactly what's in scope — and how changes are priced
Maintenance / retainerRegular sessions after the main projectFrequency, notice period, what each visit covers

Whatever the structure, the terms were explained before work began (Lesson 3). The estimate applies them to this project.

What drives the time estimate

Consulting fees usually depend on time, and time depends on factors the organizer only fully understands after assessment:

  • Volume — how much there is, and how much of it needs a decision.
  • Decision speed — some clients decide in seconds; others need time with each item.
  • Category difficulty — paper and sentimental items are slow; kitchen utensils and linens are quick.
  • People involved — every extra decision-maker adds discussion time.
  • Access and physical factors — stairs, distance to the car, storage off-site, the client's own physical needs.

Honest ranges and stated assumptions

Because so much depends on decision speed and volume, a good estimate is a range with its assumptions written down: "Eight to twelve sessions, assuming the garage stays out of scope and donation pick-ups happen weekly." When an assumption changes, everyone can see why the estimate changes too.

Supplies are estimated after shopping the house, so the client only buys what's still needed. Vendor costs come from the vendors' own quotes. Make clear whether the client pays vendors directly or through the organizer, and disclose any commission, referral fee or mark-up (Lessons 8 and 17).

When the estimate won't hold

Estimates are estimates. When the organizer can see the project will exceed it — more volume than expected, slower decisions, a vendor's price rise — the client hears about it early, with the reason and the options, and approves any spending beyond the agreed estimate before it happens. Lesson 15 covers tracking the budget during implementation.

🎯 How the exam tests III.G. Watch for the timing of the estimate and for hidden costs. Right answers estimate after assessment, use ranges, include every cost area and disclose financial interests. Wrong answers give an exact total on the first call, quote low to win the booking, or leave out vendor and removal costs.

When the Plan Needs to Change

Scope changes are the most common way a well-made plan goes wrong — not because change is bad, but because it isn't agreed. The process is simple:

StepWhat the organizer does
1. AcknowledgeWelcome the request: "Happy to look at the garage with you."
2. Explain the impactExtra sessions, extra cost, and any effect on the agreed priorities or deadline
3. Agree in writingThe client decides — add it now, add it as a later phase, or leave it out
4. Update the planRevise the timeline, estimate and task list so the plan stays accurate

Not every change comes from the client. A delayed delivery, a vendor cancellation, an illness or a new deadline all change the plan too. The response is the same: tell the client promptly, explain the effect, and adjust together. Lesson 14 covers scope creep in more depth.

Finalizing the Plan (III.H)

The final step pulls everything from Domain III into one written plan that the client reviews and approves. A complete plan typically includes:

  1. The client's goals, in their own words
  2. Scope — what's included and excluded
  3. Priorities and the order of work
  4. Tasks, with owners
  5. Resources, referrals and removal routes
  6. Timeline and session schedule
  7. Cost estimate and payment terms
  8. How progress will be reviewed, and how changes will be handled
One-page project plan with sections for goals, scope, priorities, tasks and owners, resources, timeline and costs, and a space for client approval.

Walking the client through it

Handing over a document isn't the same as agreeing a plan. The organizer goes through it with the client, in plain language, section by section. Good practice is to invite questions, check understanding ("What do you see as the first thing we'll tackle?"), and adjust anything that doesn't feel right. A plan the client doesn't understand is a plan the client won't follow.

Getting approval

The client approves the plan — not the organizer, not a vendor, and not automatically the person who made the first call. Where several people are involved, the decision-maker was agreed back in Domain I (Lessons 2 and 3). Approval is best recorded in writing, alongside the agreed terms, so both sides have the same reference point when questions come up later.

A living document

Approval starts implementation; it doesn't freeze the plan. As the project runs, the plan is updated when priorities shift, when the timeline moves, or when the client agrees a change. Keeping it current means the organizer and client are always working from the same page — literally. It also becomes the baseline for measuring satisfaction in Lesson 15 and effectiveness at follow-up in Lesson 16.

🎯 How the exam tests III.H. Look for who approves and when. The right answer has the client reviewing and approving the full plan before implementation begins, and changes communicated and agreed as the project runs. Wrong answers start work before approval, let a family member or vendor approve, or treat the plan as fixed once signed.

Exam Traps for III.F–H

If an answer……it's probably wrong because
Schedules everything in the final week before a deadlineNo buffer, no room for decisions or vendor delays
Bases the timeline on another client's paceTimelines are built around this client's energy and availability
Gives an exact total before assessmentWithout assessment it's a guess; explain the fee structure instead
Quotes low to secure the bookingMisleading — and the later "adjustment" breaks trust
Starts extra work to keep momentumChanges to scope, time and cost are agreed first
Refuses all changes once the plan is signedThe plan is a living document
Lets the organizer finalize the plan aloneThe client reviews and approves it
🧭 Scenario spotlight — Lesson 9. Two weeks into a whole-home project, Grace asks whether you can "also quickly do the garage" during Friday's session. The garage wasn't in the agreed scope. What should the organizer do? Acknowledge the request, explain how adding the garage would affect the timeline and cost, and agree any change with Grace — in writing — before starting on it. Friday's session continues with the planned work unless she chooses to reprioritize. The traps are starting the garage on Friday to be helpful, or refusing any change outright. The plan is a living document, and changes are agreed before they happen.
Knowledge Check · ~4 Minutes
🧠 Lesson 9 Knowledge Check

10 questions in the style of the CPO® exam. Score 70%+ to mark this lesson complete.

🎯 Key Takeaways from Lesson 9
  • III.F–H complete the plan: timeline, cost estimate and the final, approved plan.
  • Build timelines from deadlines (planning backward), the client's energy and availability, dependencies, between-session tasks and buffer.
  • Size sessions to the client, put decision-heavy work early, and place buffer before the deadline.
  • Estimate consulting fees, supplies, vendors and removal — after assessment, as honest ranges with stated assumptions.
  • Agree any change to scope, time or cost with the client before the extra work starts; tell the client early if an estimate won't hold.
  • The client reviews and approves the full plan before implementation; it stays a living document.
✅ Your Lesson 9 Action Steps

Before moving to Lesson 10:

  1. Pick a deadline in your own life and plan one organizing project backward from it, with buffer.
  2. Write a sample estimate as a range, with two or three stated assumptions.
  3. Draft a one-page plan outline using the eight headings above.
  4. Complete the knowledge check above and review any question you missed.
MI
Written By
Meera Iyer
Lifestyle, home & mindful living writer at The Flex Cult. A former UX designer, Meera is working through the BCPO exam content outline domain by domain, alongside the home-organisation guides she already writes. Based in Bangalore, Karnataka.
View Profile →
Independent study resource. The Flex Cult is not affiliated with, endorsed by, or acting on behalf of NAPO or the Board of Certification for Professional Organizers (BCPO). This lesson is free exam-prep content, written originally based on the publicly available BCPO exam content outline. It does not count toward CPO® eligibility hours or continuing education. General education only — not medical, mental-health or legal advice. Professional organizers don't diagnose or treat health conditions; rules on business, contracts and data vary by country and region.
Frequently Asked Questions
Which part of the CPO exam does this lesson cover?
Domain III, Project Plan Development (16% of the exam), outline items III.F (establish project timeline), III.G (estimate cost — consulting fees, supplies, vendors) and III.H (finalize project plan).
How do organizers build a project timeline?
Around the client's deadlines, energy and availability, plus dependencies such as vendor bookings and donation pick-ups, between-session tasks, and buffer time for delays. With a fixed deadline, they plan backward from it.
Should an organizer give a fixed price before assessment?
Usually not. Before assessment, the organizer explains how fees work. After assessment, they give an estimate — often as a range with stated assumptions — covering fees, supplies, vendors and removal.
What happens if the project is going to exceed the estimate?
The organizer tells the client early, explains why and what the options are, and gets approval before any spending beyond the agreed estimate.
What happens if the client wants to add to the project?
The organizer acknowledges the request, explains the effect on timeline and cost, and agrees the change with the client — ideally in writing — before the extra work begins.
Who approves the project plan?
The client. The organizer walks them through it, adjusts anything that doesn't feel right, and gets approval before implementation begins.
